Why have LNGL shares fallen so much?
Investors have seen LNGL shares fall materially since the peaks seen in May 2015. We attribute this to a number of factors:
■
Internally, the company has not hit the guided milestones (eg FEED and binding tolling agreements). Financial close, guided to be mid-2015 in 2013, has thus been pushed out. Delays not only disappoint investors on timing and execution, but may also signal a reduced probability of the projects going ahead. The project not going ahead continues to be a risk, we believe Magnolia remains attractive as a project to invest in for reasons we state later in the report. We also note that capital investment required in the plants has increased notably, reducing the value of the project to investors, despite increased revenues (vs previous expectations).
■
External factors include declining investor sentiment (and an emerging strong correlation with the falling oil price). These headline declines could well have had an impact on the confidence of potential tolling partners to sign agreements.
As can be seen in the charts below, there is a very strong relationship between the shares and the oil price, with an R2 of more than 0.85 since May 2015.
Exhibit 1: Share price (US$/ADR) vs Brent, $/bbl
|
Exhibit 2: Share price (US$/ADR) vs Brent
|
|
|
Source: Bloomberg, Edison Investment Research. Note: CO1 Comdty is Brent
|
Source: Bloomberg, Edison Investment Research. Note: CO1 Comdty is Brent
|
Exhibit 1: Share price (US$/ADR) vs Brent, $/bbl
|
|
Source: Bloomberg, Edison Investment Research. Note: CO1 Comdty is Brent
|
Exhibit 2: Share price (US$/ADR) vs Brent
|
|
Source: Bloomberg, Edison Investment Research. Note: CO1 Comdty is Brent
|
We attribute this relationship to investors linking the value to the chance that the projects reach project sanction and to the eventual EBITDA margin captured by the projects. We believe that both are heavily related to the underlying LNG pricing that LNGL’s prospective tolling partners believe they will be able to achieve. LNGL is running long-term projects, for which the short-term oil price is not as important as we believe investors attribute it to be.
LNGL has tracked Brent in a similar way to other peers, so is not alone. General market sentiment has fallen, taking many companies with it. Cheniere Energy, Golar LNG and Kinder Morgan have all been victims alongside LNGL. It is worth noting that although the correlation with the oil price has been to a high level in the past, the degree of this correlation (as measured by R2) was particularly strong in 2015 (see Exhibit 4).
Exhibit 3: Correlation of share prices with Brent oil price (trailing six-month basis)
|
Exhibit 4: Coefficient of determination with Brent oil price (trailing six-month basis)
|
|
|
Source: Edison Investment Research, Bloomberg
|
Source: Edison Investment Research, Bloomberg
|
Exhibit 3: Correlation of share prices with Brent oil price (trailing six-month basis)
|
|
Source: Edison Investment Research, Bloomberg
|
Exhibit 4: Coefficient of determination with Brent oil price (trailing six-month basis)
|
|
Source: Edison Investment Research, Bloomberg
|
Looking ahead implies a slow recovery in LNG prices
Long-term LNG margins should recover given continued LNG demand, recovery in oil pricing and healthy US natural gas supply keeping a lid on Henry Hub pricing
While the headline Brent pricing may have seen good correlations with the share price in recent months, it should not necessarily be the best guide to the future value of the company. Once the project is running, the company’s value should be independent of LNG or gas pricing (assuming a purely tolling agreement model).
Until then, it is clear that investors are using the oil price as a proxy for long-term confidence in LNG/energy demand, which itself may be seen as a measure of confidence in the project going ahead. Should investors want to see relationships between oil, gas pricing and LNG realisations, we calculate a forward price for LNG margins based on the differential between Henry Hub and Japanese LNG pricing (with forward movements based on movements with Brent 30 days previously). This shows that the LNG margins have suffered more than Brent, mainly despite Henry Hub prices moving down in recent months.
In the longer term, LNG pricing should recover and increase to a greater extent than Henry Hub pricing, providing more robust LNG differentials for LNG traders. On these data, the differentials are unlikely to reach the levels hit in 2012, but we believe margins of around US$5/mmbtu are not at a level to allow LNGL’s tolling partners to make profits. Thus the differentials will have to expand from the prices implied by this analysis if any future US-based LNG projects are to be justified.
Exhibit 5: Brent vs LNG pricing over time
|
Exhibit 6: LNG differentials from Henry Hub, past and future
|
|
|
Source: Edison Investment Research, Bloomberg. Note: CO1 Comdty is Brent, JK1 is Japanese LNG pricing
|
Source: Edison Investment Research, Bloomberg. Note: Implied future is defined by historical relationship of LNG prices to Brent, using our assumptions on long-term Brent price of US$70/bbl. We note that forward curve is much flatter than Edison’s 2023 assumption of US$53/bbl
|
Exhibit 5: Brent vs LNG pricing over time
|
|
Source: Edison Investment Research, Bloomberg. Note: CO1 Comdty is Brent, JK1 is Japanese LNG pricing
|
Exhibit 6: LNG differentials from Henry Hub, past and future
|
|
Source: Edison Investment Research, Bloomberg. Note: Implied future is defined by historical relationship of LNG prices to Brent, using our assumptions on long-term Brent price of US$70/bbl. We note that forward curve is much flatter than Edison’s 2023 assumption of US$53/bbl
|
EPC contract moves project forward
Over recent months, LNGL signed a lump sum turnkey contract with KBR lead KSJV and set up strategic alliances with Siemens, Chart and EthosEnergy. These set clear benchmarks on costs for the project, with targets for contractors to complete work on time and on budget. Further clarification on “other costs”, including ramp-up gas, insurance, O&M fees and others, have also been clarified and set. These add up to a materially larger capex bill (see later section), but give a far greater confidence in the new estimates and involve a number of marquee names.
The contract was summarised by LNGL as follows:
■
An EPC Contract LSTK cost of US$4.354bn for four LNG trains and associated facilities.
■
EPC guaranteed production of 7.6mtpa, or 0.8mtpa greater than previous guidance.
■
The EPC Contract LSTK plant design utilises LNGL’s patented OSMR technology.
■
Installed capacity EPC contract cost/tonne range of US$495 to US$544 based on final design at FID.
■
LNG plant fuel gas consumption of 8%, or 92% feed gas production efficiency guaranteed.
■
EPC Contract LSTK price is valid to 31 December 2016 (was previously to 30 April 2016).
■
We note that “other costs” of 13.5-15.5% of the EPC contract are expected.
Next steps: Awaiting binding tolling agreements and FERC Notice to Proceed
An excerpt from the FERC website (in Exhibit 7) gives an idea of the progress of Magnolia through the regulatory process. On 18 April, the company received the FERC order, step 17 of 20 in the regulatory cycle. As a result, only a few steps remain before the Notice to Proceed.
We note that the milestones achieved are still high and do not show a number of the important steps that have also been taken. These include the Schedule for Environmental Review, and submission of the Draft Environmental Impacts statement (DEIS) and the Final Environmental Impact Statement (FEIS). Progress made on non-FTA status is also excluded.
Exhibit 7: EA pre-filing Environmental review process
|
|
|
The project is awaiting a number of major final milestones before financial close. Until these are complete, the company has put the EPC and related contracts on hold to minimise cash burn, while enabling the projects to ramp up quickly once all the pieces are in place.
In particular, we would highlight the following
■
Final regulatory approval will result in a FERC NTP, which is the final regulatory step required to allow the project to start up. The required regulatory waiting times have now elapsed, meaning the NTP may be issued at any time.
■
On the commercial side, the project has a 1.7mtpa contract with Meridian, but needs binding contracts with tolling partners for the remaining volumes before financial close. From the FERC documents “Magnolia states that it has executed non-binding agreements with four potential customers, Brightshore Overseas, Ltd, Gas Natural Fenosa, LNG Holdings Corp., and AES Latin America Development Ltd, for approximately 6.1 MTPA of firm capacity and approximately 0.3 MTPA of interruptible capacity collectively.” The underlying market conditions have meant delays in signing contracts vs previous expectations.
■
Financially, we believe the agreement with Stonepeak is on a firm footing. With Stonepeak having recently raised a further US$3.5bn (raising its assets to US$5.7bn), it has the capacity to increase its investment if it chooses without the Magnolia investment becoming an overly large part of its portfolio. We currently assume a cap of US$900m of equity at Magnolia and US$0 (zero) at Bear Head, for which Stonepeak requires a 14% pre-tax IRR.
■
Another step that would enhance the value of the project is non-FTA approval for volumes. We do not believe this is required for the project to get the go-ahead, but it would be useful for negotiations with tolling partners.
Changes to project and modelling
We have made a number of changes to our modelling, given recent newsflow and developments.
Increased capex: we have firmed up our capex estimates following the announcement of the contract, moving capex to US$4.4bn for four trains (two phases). This is a significant increase from our last assumptions, but the project lies on a firmer basis with higher guaranteed volumes (7.6mtpa, 0.8mtpa greater than previously). The cost per ton remains at the lower end of global projects, so should still be attractive to LNGL’s tolling partners looking for commercial advantage.
The additional cost does bring the funding of the development into greater focus. Even with debt funding doing the majority of the heavy lifting (and with Stonepeak’s contribution helping), the additional capital investment required means that LNGL will need to find equity funding of its own for the project (most probably for trains three and four). This may come from an additional equity partner in the Magnolia project itself (perhaps as part of a deal on the offtake) or at group level. However, shareholders are likely to see their existing holding in the project reduced to fund it. On a non-discounted basis, this shortfall amount totals around US$200m by 2019 for Magnolia (although this will depend on the tolling fees achieved and the equity LNGL retains as a result). In our valuation, we account for this cash shortfall by taking the NPV10 of the capital in the projects and applying a 15% cost of equity.
The addition of a success/production payment to the contractors was not something we had previously assumed. The payment of $0.07/mmbtu for production means cash outflow of up to US$30m per year from the project.

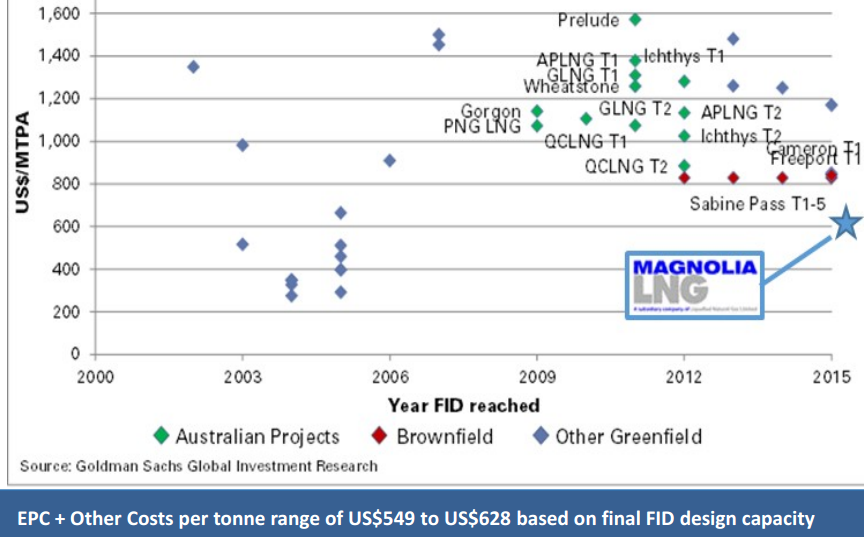

Exhibit 8: Magnolia at low end of cost curve
|
Exhibit 9: Global LNG NPV10 break-evens
|
|
|
|
Source: Ophir Energy. Note: Green bars are LNG schemes in which Ophir is involved.
|
Exhibit 8: Magnolia at low end of cost curve
|
|
|
Exhibit 9: Global LNG NPV10 break-evens
|
|
Source: Ophir Energy. Note: Green bars are LNG schemes in which Ophir is involved.
|
Increased revenues/EBITDA: we had previously anticipated EBITDA of US$2.00/mmbtu, as guided by the company in 2014. This has increased following the realisation that higher capital costs will require higher fees to achieve required rates of return. An analysis of peer projects indicates that US$2.75/mmbtu would still be at the lower end of the peer spectrum and should still encourage investment by tolling partners. However, recent market changes are likely compressing margins and we expect that tolling partners will require lower charges to make returns for their trading operations. For the moment, we assume a US$2.30/mmbtu margin, but are aware that there is notable uncertainty in this expectation.
We retain a tax rate of 38% (although in the fullness of time this may turn out to be too low as the company may be able to negotiate state tax breaks).
Exhibit 10: Summary of selected tolling fees at peers
Company |
Client |
Fee, US$ per mmbtu |
Gas sourcing cost |
Timescale |
Cheniere |
BG |
$2.25-3.00 |
115% of Henry Hub |
20 years |
Cheniere |
Gas Natural Fenosa |
$2.49 |
115% of Henry Hub |
20 years |
Cheniere |
KoGas |
$3.00 |
115% of Henry Hub |
20 years |
Cheniere |
GAIL |
$3.00 |
115% of Henry Hub |
20 years |
Cheniere |
Total |
$3.00 |
115% of Henry Hub |
20 years |
Cheniere |
Centrica |
$3.00 |
115% of Henry Hub |
20 years |
Golar LNG |
Ophir |
$3.50 (+$0.5/for mods) |
|
Debt financing: we had previously estimated that 70% of the project would be debt financed. We have increased this to 75% as the plants from Freeport LNG and Cameron LNG have reportedly achieved this level. IHS CERA has estimated that since 2000 LNG projects have on average used debt financing of 71% since 2000. The project will have low political risk (being in the US), although the new application of technology may require a small risk premium (albeit this should be offset materially by the EPC guarantee volumes). Looking at Exhibit 11, we would expect this percentage to need revision if the project is not fully derived through long-term contracts.
We continue to assume a debt cost of 7.5%, but note that the rate arrived at will have a material impact on the project, given the high percentage of debt funding. A 1% increase in this rate would decrease the total project NPV by c 4%. Given Stonepeak’s fixed return, it would have a greater impact on LNGL’s equity stake.
These factors result in a lower NPV for LNGL’s stake: the increased equity investment from Stonepeak and the higher capital investment for the project results in a lower NPV.
Exhibit 11: Debt can take on a greater role as long-term contracts increase as a percentage of output
|
|
Source: https://www.diw.de/documents/publikationen/73/diw_01.c.494837.de/dp1441.pdf
|
We have taken the opportunity to push Bear Head further into the future. While the project should be strongly value accretive for LNGL, the development process has not been as fast as we had expected and has delayed our timelines. A clear line of sight to gas supply is required before tolling partners can be brought in. However, the state of the site and progress on permitting (including a recent authorisation from the US DOE for gas exports to the project) should enable swift progress on the project once gas supply is secured. We note that options for gas supply remain either sourced from the Marcellus Shale in the US or from discoveries/prospects offshore Nova Scotia.
Non-FTA approval for Bear Head is encouraging
On 8 February, the US DOE issued final authorisation for Bear Head to export LNG derived from US-produced natural gas to countries without free trade agreements with the US. Bear Head is now the first and only proposed Canadian LNG export facility to obtain non‐FTA authority and all the initial regulatory approvals to commence project construction, with approvals achieved in less than 12 months. The DOE also declared that no permit was required for any Canadian gas to go through US pipelines in transit to the site.
These elements remove a key risk for the project and its ability to source gas from a range of sources. Currently, we assume that gas will either come from onshore gas supplied from the US (probably shale gas from the Marcellus) or from offshore Nova Scotia. These permits now clear the way for the project to source from either of the sources and export globally, which should increase the attractiveness of the project to both tolling partners and potential equity partners.
Other news – personnel changes
On 4 April 2016, LNGL announced that Maurice Brand, founder and long-time MD, was stepping down. He is to be replaced by Gregory (Greg) Vesey, a professional with 35 years’ experience at Chevron where he was responsible for global gas marketing and trading activity including extensive LNG development work. His previous appointments covered the introduction of new technology, international operations and included commercial and execution responsibilities as well as liaising with stakeholders. Maurice Brand will continue as an executive director (based on his existing Employment Agreement) until his retirement by June 2017.
On 20 November 2015, LNGL announced the appointment of Anthony Gelotti as chief development officer based in Houston, Texas, US. He brings a wealth of experience from Chevron LNG supply and trading.
LNGL also announced that Mr John Baguley, chief operating officer for Magnolia LNG will assume the additional responsibilities of LNGL’s chief technical officer. John, who is based in Houston, replaced Mr Paul Bridgwood, who wished to remain in Perth and left the company on 30 November 2015.
On 18 August 2015, LNGL announced the appointment of Ms Kinga Doris as general counsel and joint company secretary, based in Houston, Texas, US.
